Can You Start Renovation Work With a Declaración Responsable?

  • 2 months ago
  • 0
Hands poised to sign declaration form

A correctly filed declaración responsable obras generally lets you start qualifying works immediately, but it never removes your legal responsibility if something is wrong. Spain’s LISTA framework and municipal model forms treat the declaration as a promise, backed by paperwork, that your project meets the rules. Before you touch a wall, have two things ready:

  • Technical documentation matching the municipal model (plans, budget, and a signed project when required).
  • Proof of ICIO payment or autoliquidation, since most Sede Electrónica portals won’t process the filing without it.

A bathroom retile or a rooftop solar install usually qualifies. Knocking down a load-bearing wall or altering a protected façade almost never does, and filing a declaración responsable for that kind of work invites a suspension order rather than a green light.

Key Takeaways

A declaración responsable lets qualifying renovation work begin immediately in most municipalities, but the owner remains fully responsible for accuracy and documentation throughout any posterior review.

PointDetails
Confirm eligibility firstStructural changes, façade alterations, and heritage properties usually require a full licence, not a declaration.
Pay ICIO before filingAttach your autoliquidation receipt, since Madrid sets a provisional rate of 3.75% of the execution budget and other municipalities require proof upfront.
Match your municipality’s timing ruleSome towns allow immediate start, while Ciudad Real requires a 15 day wait after submission.
Keep the full dossier on siteInspectors can request documentation months after filing, and a missing document is the most common cause of suspension.
Get professional coordinationSteramflats manages técnico liaison, tax filing, and posterior follow-up so the dossier stays audit ready from day one.

Official Pages Worth Bookmarking Before You File

Consult Málaga’s model form and the Junta de Andalucía guide for annexes and checklists before submitting.

Table of Contents

A declaración responsable is a sworn statement, not a permit. You, as the owner, certify that the work complies with planning rules and that you already hold the technical backup to prove it. Andalucía regulates the mechanism through LISTA and the LOUA, and the Junta de Andalucía’s practical guide sets out which acts qualify, along with model annexes municipalities use to check submissions.

The difference from a licencia de obras is timing. A licence requires the town hall to review and approve before you start; a declaración responsable flips that order, giving you immediate effect on registration while the administration reserves the right to check afterward. That trade favors speed over certainty. Each municipality applies its own annexes and thresholds, so a project treated as minor in Málaga might need a full licence in a neighboring town. The administration’s posterior control power doesn’t expire once work begins, and a bad filing can still get shut down mid renovation.

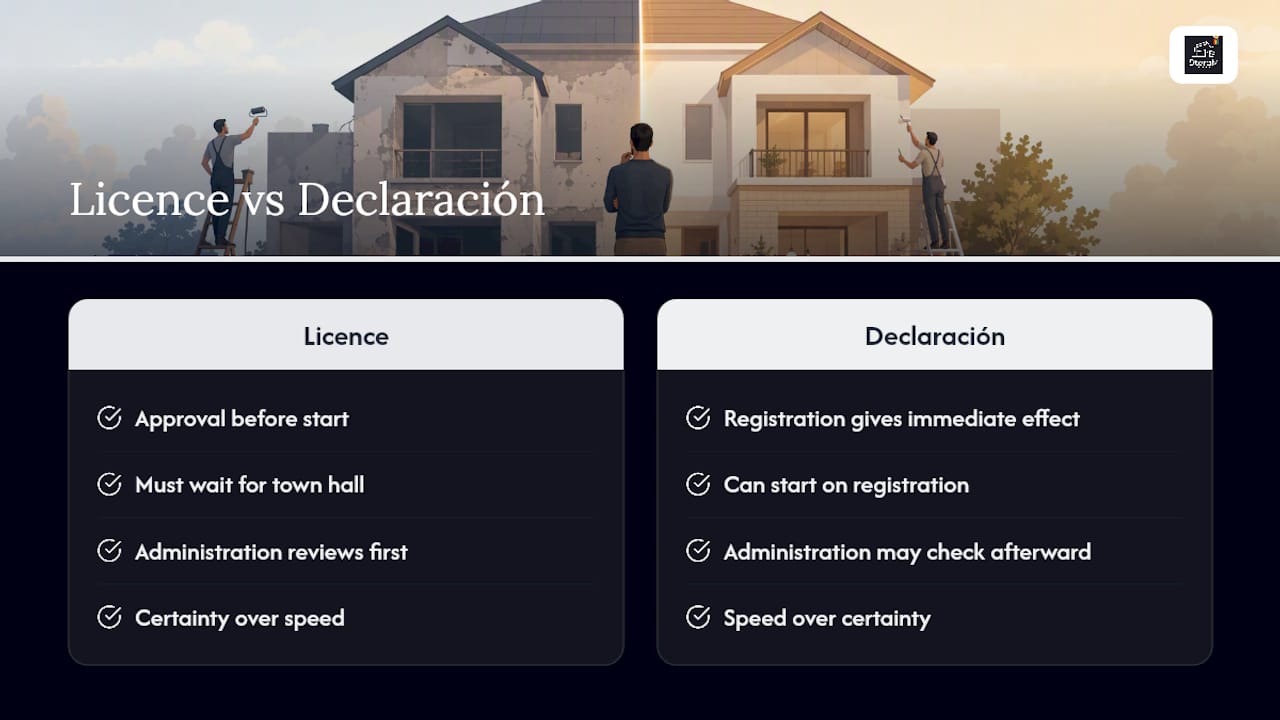

Comparison diagram of license versus declaration

Which Works Qualify for a Declaración Responsable?

Most interior renovations that don’t touch structure fit the regime, along with a growing category of energy upgrades. Typical qualifying works include:

  • Interior renovations that don’t affect structural elements (kitchens, bathrooms, partition walls).
  • Renewable energy installations like rooftop solar panels or heat pump units.
  • Minor changes of use that don’t add dwellings or increase built volume.

Exclusions matter just as much as inclusions. Structural interventions, changes to façades or overall building volume, anything touching a heritage-protected element, and most works on rural land (suelo rústico) beyond limited energy improvements fall outside the declaración responsable track. Heritage cases deserve special caution: waiting for a posterior inspection to find out your work needed a heritage commission review can mean costly reversal rather than a simple fine.

Local PGOU plans and municipal ordinances can narrow or widen this list. Always check your town’s specific annex before assuming your project qualifies.

Who Signs the Declaration and What Documents Do You Need?

The declarant, meaning you as owner or your legal representative, carries ongoing legal responsibility for everything stated in the filing. That responsibility doesn’t transfer to your builder or your neighbor’s architect. Málaga’s municipal guidance is explicit that owners must keep technical documentation available for municipal checks, not just at the moment of filing.

Hands holding technical blueprint outdoors

Whether a técnico needs to sign your project depends on scope. Minor works with no structural implications often need only a descriptive memory you can write yourself, while anything touching load distribution, fire safety, or accessibility typically requires a project signed and visado by an architect or technical architect.

Your document checklist should include:

  1. The municipal model form, filled out with your details and cadastral reference.
  2. Valid ID and proof of ownership or representation.
  3. A descriptive memory of the works, plus before and after plans.
  4. An itemized execution budget.
  5. A technical project or memos, when the scope requires professional sign off.
  6. A safety and health study, if the work’s risk profile calls for one.
  7. The ICIO autoliquidation receipt, attached as proof of payment.

Pro Tip: Keep every document in one PDF with a cover index that mirrors the municipal checklist item by item. Inspectors move faster through an organized dossier, and a fragmented submission is one of the easiest ways to trigger a request for more paperwork.

What Taxes and Fees Apply, and When Can Work Begin?

ICIO, the tax on constructions, installations, and works, applies in nearly every municipality, but the rate is set locally. Madrid’s Sede Electrónica sets its provisional ICIO at 3.75% of the material execution budget, and you calculate and pay it yourself through autoliquidation before the town hall reviews anything.

Beyond ICIO, watch for smaller municipal fees tied to the physical footprint of your work:

  • Tasas for occupying public space with scaffolding or fencing.
  • Fees for using vallas or containers on the street during construction.
  • Additional charges some municipalities apply to works near protected zones.

Timing varies by town. Some municipalities give immediate effect on registration; Ciudad Real sets a 15 day window after submission before work can legally start, giving officials time to flag problems. Whatever your town’s rule, keep the payment receipt on hand. Some municipalities, like Murcia, require the autoliquidation attached to the filing itself, not paid afterward.

How Do You File a Declaración Responsable Step by Step?

Filing runs cleaner when you treat it as two phases: preparation, then submission.

  1. Confirm which municipal model form applies to your specific type of work and pull the matching annex.
  2. Assemble your technical documents, plans, budget, and any required project or memos.
  3. Calculate and pay ICIO and any applicable municipal fees, keeping the autoliquidation receipt.
  4. Get técnico signatures or visado where the scope requires professional sign off.
  5. Sign the completed package with your digital certificate.
  6. Submit through the town’s Sede Electrónica, or present it in person at the registro if you prefer a physical receipt.
  7. Where available, an Entidad Colaboradora Urbanística can review and validate your file before it reaches the town hall, which often speeds up posterior checks.

Pro Tip: If your portal splits the submission into multiple uploads, reference the first registration number in every subsequent file. A fragmented submission with no cross reference is exactly what makes municipal reviewers request extra documentation weeks later.

Keep a full copy on site once you start work. If an inspector shows up, you want the registered receipt and the technical dossier within reach, not buried in an email thread.

What Happens If the Administration Finds a Problem Later?

Municipalities retain full inspection power after registering your declaración responsable, and that check can happen months into your renovation. Málaga’s municipal page is direct about what triggers action:

Essential inaccuracies, missing mandatory documentation, or works that exceed the declared scope can lead to suspension of the works or a declaration that the filing is ineffective.

Common triggers include false data on the form, skipping a required sectoral authorization (heritage, environmental, or industrial), or quietly expanding the project beyond what you declared, like turning a bathroom remodel into a load-bearing wall removal.

Practical response, if the town hall opens a check:

  • Have the full technical dossier ready to hand over immediately, not assembled after the request arrives.
  • Respond within the deadline stated in the municipal notice; silence is read as noncompliance.
  • If the works genuinely fall outside what you filed, stop and file a modification or a new declaration rather than continuing.

What Checklist and Mistakes Should You Watch Before Filing?

A short pre-filing pass catches most of the problems that lead to suspension later. Confirm you have: the signed model form, the ICIO autoliquidation receipt, técnico sign off where required, a heritage check if the property sits in a protected zone, and your IBI and occupancy status in order.

The mistakes that come up again and again:

  • Starting work before the payment receipt is actually in hand, not just requested.
  • Skipping a mandatory sectoral authorization because the owner assumed the declaración responsable covered everything.
  • Under-budgeting the execution cost, which understates ICIO and draws scrutiny during a later audit.
  • Assuming a technical project isn’t needed, then getting flagged when the scope turns out to touch structure.

Pro Tip: If your project sits anywhere near a gray area, structural doubt, heritage proximity, or an unusual change of use, a short consulta urbanística before filing costs far less than a suspended project halfway through demolition.

This is where a project management partner earns its fee. Coordinating técnicos, tracking municipal deadlines, and keeping the dossier audit ready is exactly the kind of ongoing work that catches owners off guard when they’re managing it alongside a full time job.

A Practitioner’s View on Filing Risk

Most owners underestimate how much the posterior control phase matters. The filing itself is the easy part. What actually determines whether your renovation finishes on schedule is whether your dossier can survive a municipal review six months in. We’ve seen projects lose weeks over a missing safety study that should have been assembled on day one. The fix isn’t more paperwork. It’s organizing the paperwork you already need to have, before you file, not after an inspector asks for it.

— YellowRock

How SteraM Flats Handles Your Declaración Responsable

Steramflats is the alternative to juggling técnicos, municipal portals, and tax calculations on your own. For owners planning a renovation in Torremolinos or elsewhere along the Costa del Sol, Steramflats coordinates the entire filing: liaising with architects and technical professionals, calculating and handling your ICIO autoliquidation, submitting through the correct Sede Electrónica, and following up if the municipality opens a posterior check.

Steramflats

That single point of contact matters most when a review turns up a missing document weeks into your project. Instead of chasing three separate professionals for a response, you have one team already holding the full dossier. Steramflats’s project management service covers licensing follow-up from the first filing through final inspection, and pairs naturally with guidance on municipal permits for smaller works when your project sits closer to that threshold.

If you’re planning renovation work and want the filing handled correctly the first time, get in touch through Steramflats’s real estate agent guide to start the conversation about your specific project.

Sources

Join The Discussion

Compare listings

Compare
Steram Flats

Instala esta web app en tu Iphone: Tap  y “añadir a pantalla de inicio“
